New Residence Hall
New Residence Hall
A new residence hall that has been years in the making is under construction near the former site of Bailey Street Apartments. The $46 million new residence hall is slated for completion in early 2022, offering students amenities that are not available in the traditional style of Residence Halls A-F, which were built in 1972.
The new residence hall will be five stories high and incorporate two wings. It will accommodate approximately 450 students in suite-style housing, offering two double or single rooms and a suite-shared bathroom space. It features multiple gaming areas, community lounges, community kitchens on the first and fifth floors, studies on each floor, and a central laundry facility on the first floor.
Construction officially got underway summer of 2020 with site preparation; the first concrete pour was in July. Trucks will be using the field behind the Fitness Center for access to the construction site from Waughtown Street, in order to keep traffic disruption on campus to a minimum.

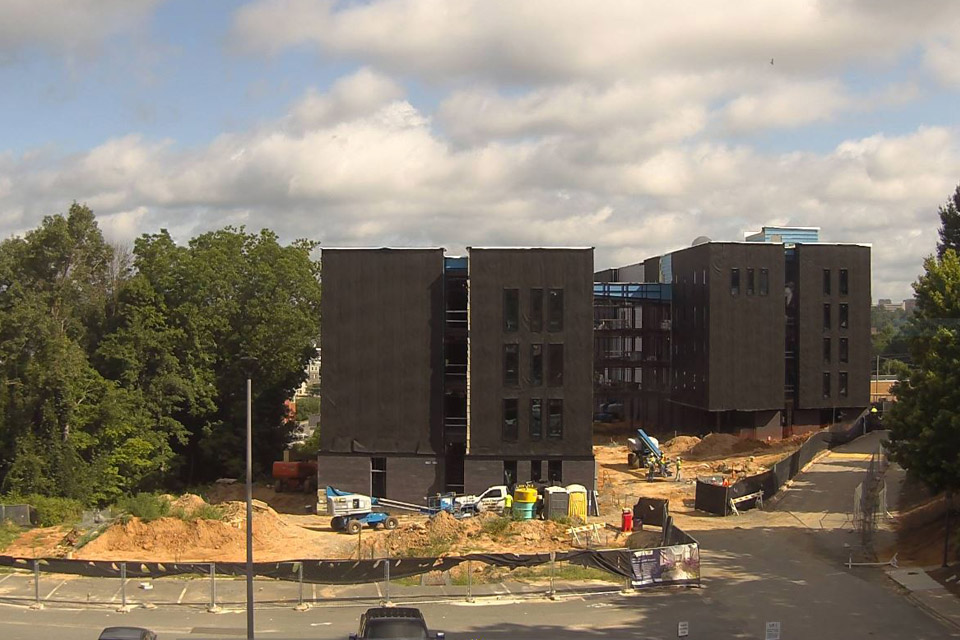

View Construction Live Cam

Watch the live camera view or a time-lapse videos of the new residence hall construction. Weekends and nights are excluded from time-lapse videos.
Timeline by the month
The following is a list of key milestones in the construction of the residence hall:
Timeline | Construction Activity |
July 2020 | Break ground at the site |
August 2020 | Begin install of plumbing, electrical, storm and sanitary infrastructure |
September 2020 | Begin pouring foundations and footings |
October 2020 | Begin mechanical, electrical and plumbing (MEP) rough-in and setting of the stairs |
November 2020 | Erect structural steel and MEP rough-in for upper floors |
December 2020 | Install roofing and preliminary parking lot paving and curb install |
January 2021 | Begin construction of the bridge (the connector) |
February 2021 | Begin install of brick veneer, metal paneling and finish roofing |
March 2021 | Begin interior build-out of upper floors and bridge |
April 2021 | Begin framing hard ceilings and install fixtures in restrooms |
May 2021 | Begin elevator install and interior paint; install site lighting |
June 2021 | Install interior storefront, doors, and signage |
July 2021 | Install carpet; furniture, fixtures and equipment (FF&E); and construct courtyard and sidewalks |
August 2021 | Finish interior punch list for East Wing; place sod and hardscape |
September 2021 | Perform test and balance of East Wing; punch list for West Wing |
October 2021 | Final inspections/commissioning for the East and West wings |
November 2021 | Perform final clean before turnover |
December 2021 | Building turnover to UNCSA |
About this project
UNCSA identified a new residence hall for college students as a priority in its Strategic Action Plan in 2015 and its Campus Master Plan, approved in 2017.
The new residence hall was designed by LS3P, a multi-disciplinary firm offering architecture, interiors, and planning services to a wide variety of clients nationwide. LS3P has offices in North and South Carolina and Georgia. The construction manager is Metcon, a Native American-owned business (Lumbee) founded in 1999 in Pembroke. Metcon delivers general contracting and construction management services for higher education, K-12, medical, corporate, and government entities throughout the East Coast.
